Dunn Creek Greenway



Snapshot

Location

This trail begins at the Smith Creek Soccer Center, 690 Heritage Lake Road, and runs north to the pedestrian culvert under NC-98 Bypass/Dr. Calvin Jones Highway.

Trail Type

Paved and boardwalk trail

Length

1.0 mile

Parking

Parking is available at the Smith Creek Soccer Center, 690 Heritage Lake Road

Amenities

A playground, picnic shelter and parking are located within the park. Portable restrooms are also available.



Phase 3 & 4 Updates

January 30, 2025

Since initiating construction activity for Phase 3, Crowder Construction and its subcontractors have installed initial erosion and sediment controls including construction driveways, silt fencing, and temporary stream crossings. Crews have also started clearing and hauling off tress within the project’s limits of disturbance. This work is expected to continue over the next few weeks.

December 16, 2024

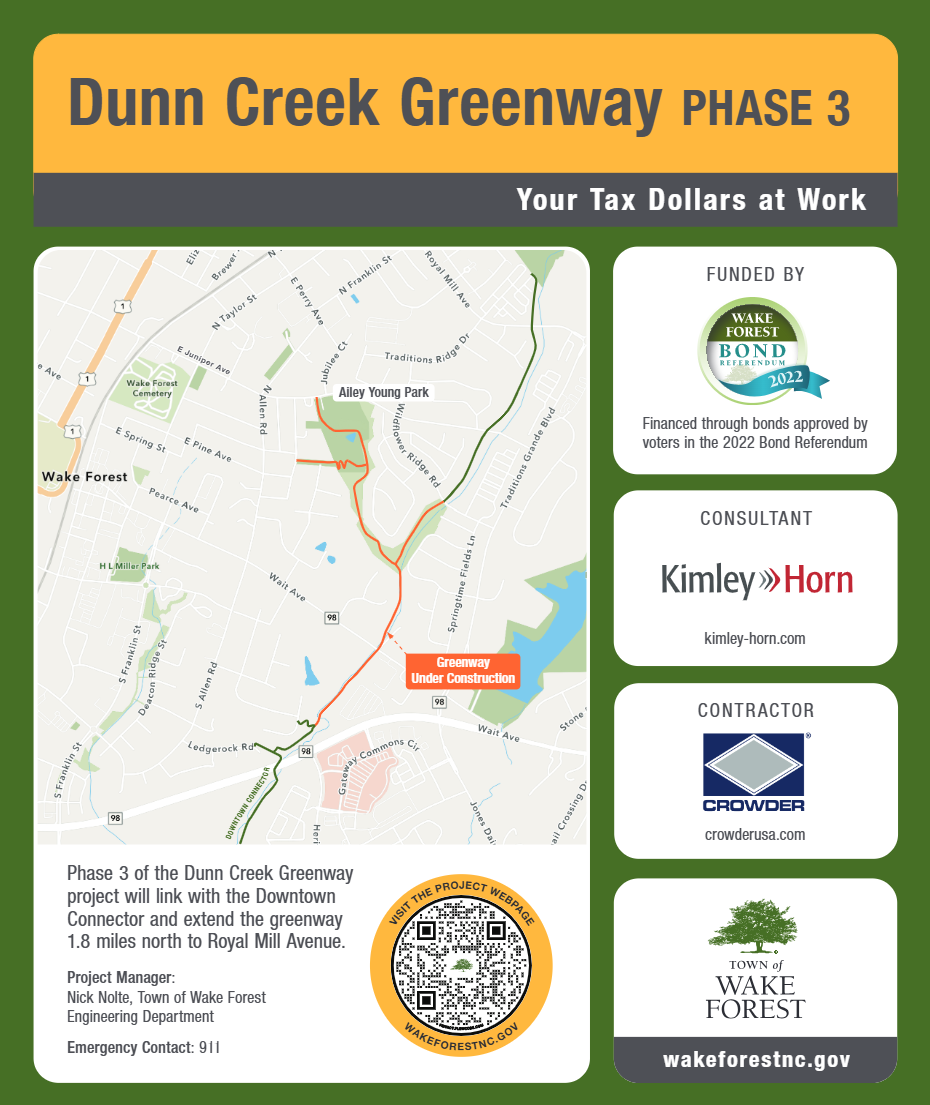

Crowder Construction has started construction on Phase 3 of the Dunn Creek Greenway.

Funded by the 2022 Bond Referendum, Phase 3 will add 1.8 miles of greenway to the Dunn Creek network. Starting at the current end of the Dunn Creek Greenway north of Dr. Calvin Jones Highway/NC 98 Bypass, Phase 3 will connect with the existing greenway alignment to Ailey Young Park and the existing greenway network constructed in the Traditions neighborhood.

Scheduled for completion in late spring 2026, Phase 3 will require the greenway to cross over Wait Avenue and three streams. The footbridges that span these streams will be constructed with precast concrete boardwalk systems, known as Permatrak, to reduce slipping conditions when wet and aid long-term maintenance and structural integrity.

Construction activity will intermittently impact traffic along Wait Avenue throughout the project, but Wake Forest will notify the public through normal channels prior to any road and/or lane closures.

Construction on Dunn Creek Greenway Phase 4, also funded with the 2022 Bond Referendum, has not yet begun, but the project must be completed within the same period as Phase 3, which means it too will be completed by late spring 2026.



Dunn Creek Greenway

History

Wake Forest Bond ReperendumIn 2005, area voters approved $500,000 in bond proceeds for trail construction. Wake Forest also received $450,000 for the project from the American Recovery and Reinvestment Act of 2009. A 1 mile segment of greenway trail from the Smith Creek Soccer Center to the NC 98/Dr Calvin Jones Highway was completed in 2012.

Greenway users have the opportunity to experience views of aquatic and wetland life along portions of Smith Creek and Hatters Branch as well as enjoy the shade of dense evergreen and deciduous forests.

Tom Stoddard memorial benches were installed in the spring 2013. Mr. Stoddard was an advocate for the Wake Forest greenways and devoted many hours to keeping the Dunn Creek Greenway looking it's best even when it was under construction. After his passing in 2013, Mr. Stoddard's family wanted to honor his memory by placing benches along the Dunn Creek Greenway.

In 2011 the Town was awarded a grant for design, ROW acquisition, and construction for Dunn Creek Greenway Phase II - Downtown Connector. This new segment add 0.3 miles to the northern portion of Dunn Creek Greenway. It provides connections to Deacons Ridge, Cardinal Park and easy access to downtown Wake Forest. Construction was completed in September 2017 and this segment is now open for public use.

More recently in 2022, Wake Forest citizens voted on and approved $14.35 million in greenway improvements as part of the 2022 Bond Referendum. This funding will help expand both the Dunn Creek Greenway and Smith Creek Greenway networks. Specifically for Dunn Creek Greenway, the construction of Phase III and Phase IV was awarded to Crowder Construction. The construction for both of these phases are expected to start in early November 2024 with the project expected to be completed by early 2026.

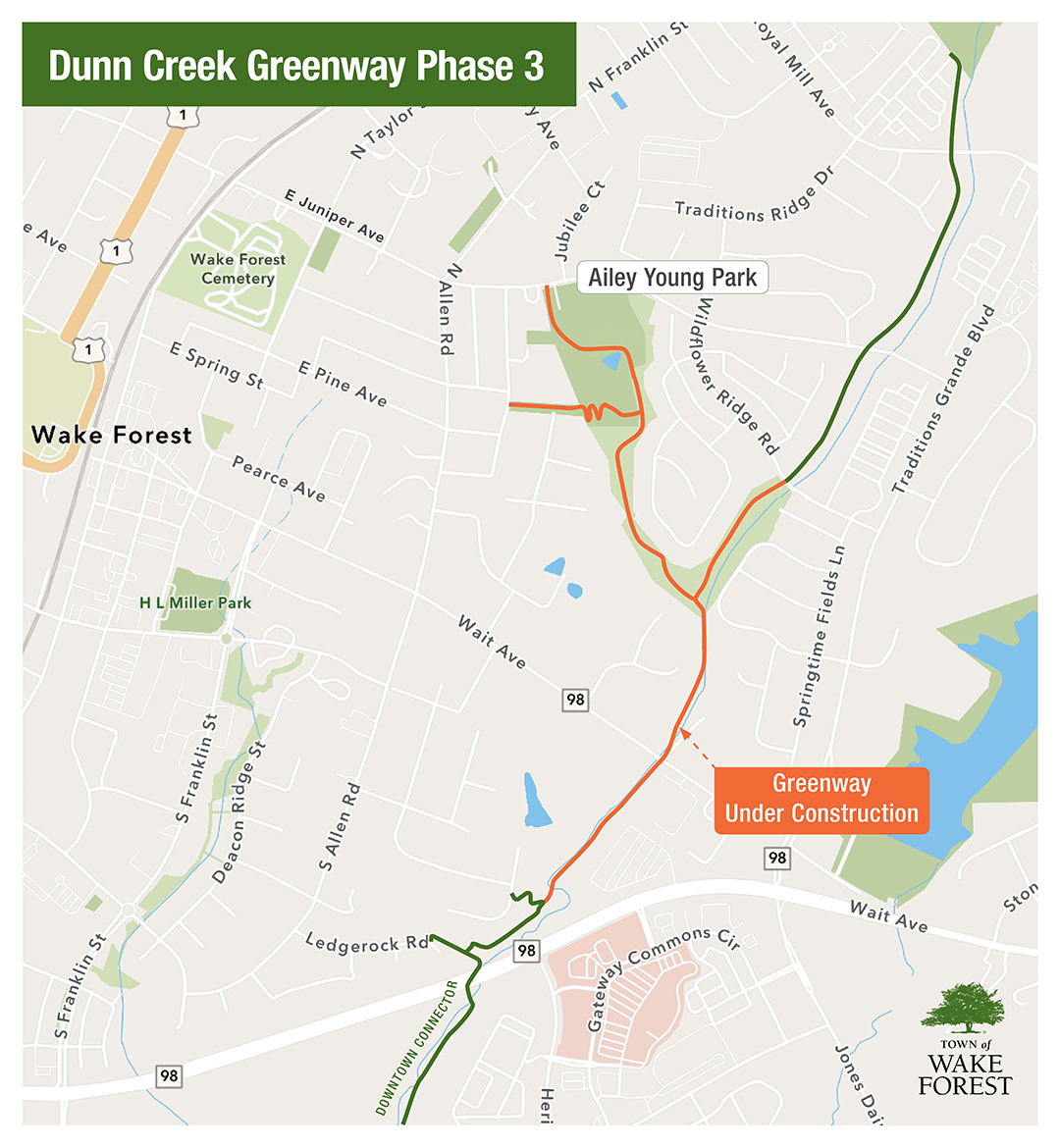

Phase 3

This section of greenway will start at the existing terminus of the Dunn Creek Greenway north of NC-98. This alignment will connect the existing greenway alignment to Ailey Young Park as well as connecting to the existing greenway network constructed with Traditions. This project will add 1.8 miles of greenway to the Dunn Creek network.

The Notice to Proceed was set on December 2, 2024, granting Crowder Construction and its subcontractors the ability to start construction.

This Phase is expected to take no longer than 480 days, which has the project completion set for March 26, 2026.

The project entails crossing over Wait Avenue (Rectangular Rapid Flashing Beacons to be installed at crossing for safe pedestrian crossing) and a few stream crossings. The footbridges over these will be constructed with precast concrete boardwalk systems, known as Permatrak, versus a wooden option to reduce slipping conditions when wet and help with long-term stability.

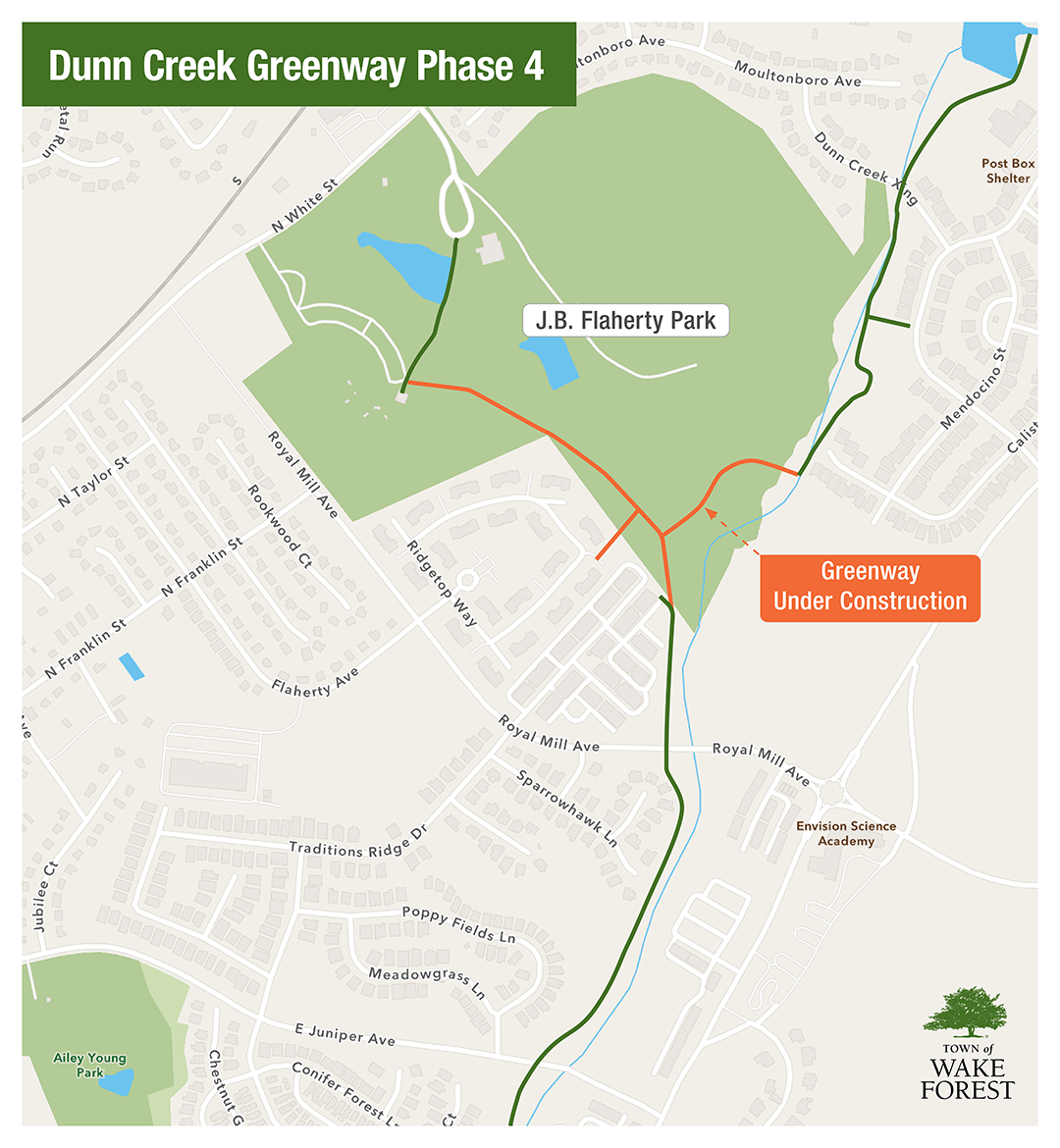

Phase 4

This section of greenway will have multiple connection points to existing greenway. It will ultimately connect Flaherty Park, Orchards at Traditions, Flaherty Farms, and the Del Webb community to the Dunn Creek Greenway, with the addition of 0.62 miles of new greenway.

The Notice to Proceed has not be set yet for this Phase, however, it is expected to take no longer than 300 days. This Phase must be completed before, or by the final day of Phase III, which is expected to be finished by March 26, 2026.

Although this Phase does not consist of a road crossing, it does include a stream crossing like Phase 3 which will have a footbridge constructed of the same material.

Construction drawings for Phase 3 and 4  can be found on the Town's IDT Website. You will need to create a login, but then you can search "Dunn Creek Greenway Phase X" to find the construction drawings. If you experience any issues doing this, please reach out to the Project Manager, Nick Nolte, for assistance.



Maps

Dunn Creek Greenway
Stormwater Utility Manager
919-435-9449
Greenway Hours

Dawn to Dusk

Contact Information

Maintenance Issues/Questions
email or call 919-554-6184

Future Trail Questions
email or call 919-435-9510

Dunn Creek Greenway Phases 3 & 4
Nick Nolte, Project Manager
email or call 919-353-7203



Dunn Creek Greenway Maps
